Weekly project status report
An 8-slide weekly status deck made from a written report for an invented customer portal migration. See each slide at full size.

Why this deck works
- The first slide gives the project, the week, and the overall status.
- Each status is a colour and a word. A reader who cannot tell red from green can read the word.
- Each risk has an effect, an owner, and an action.
- The last slide lists two decisions. Each decision has a person and a date.
The prompt that made it
GenPPT prompt

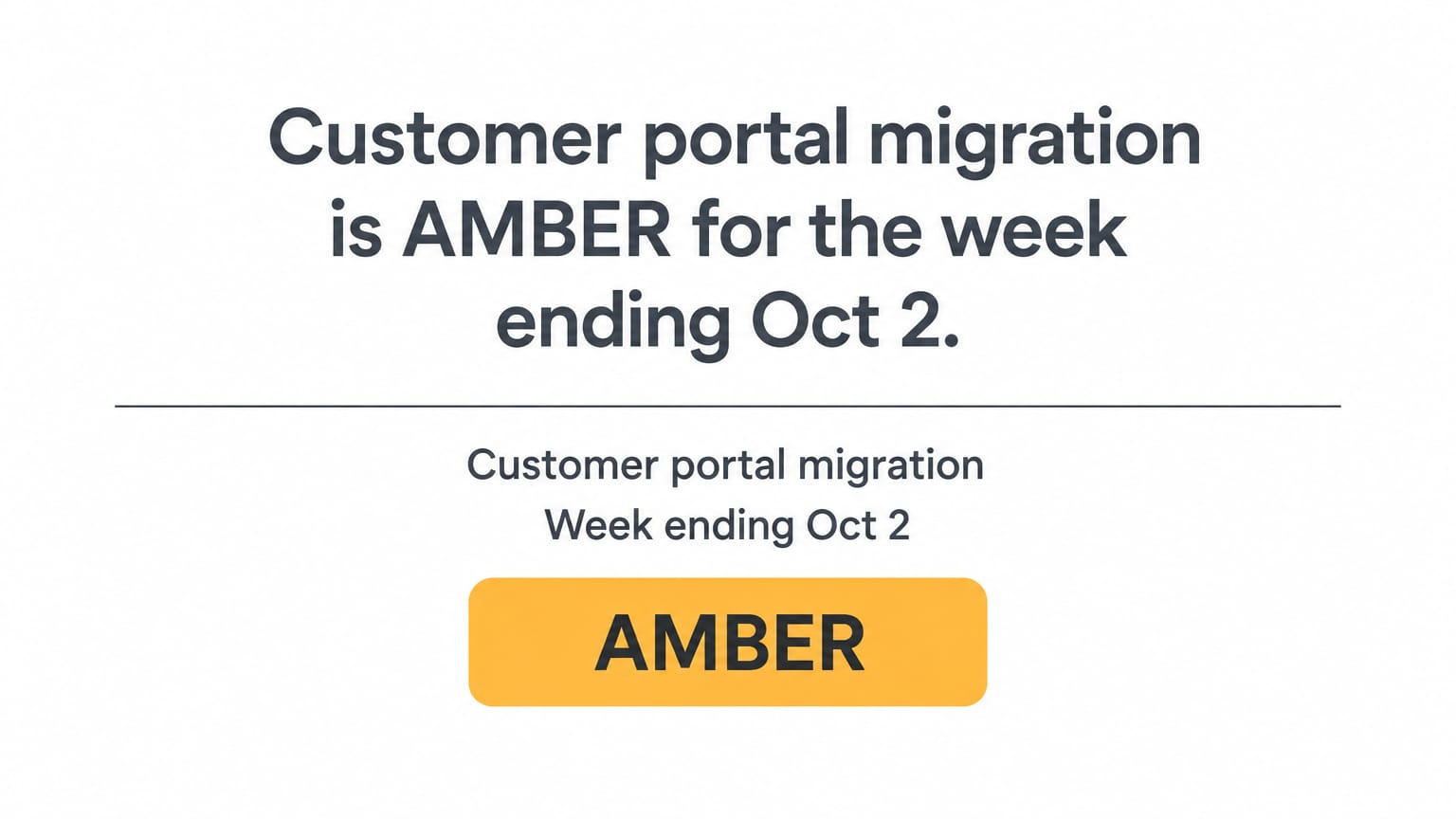

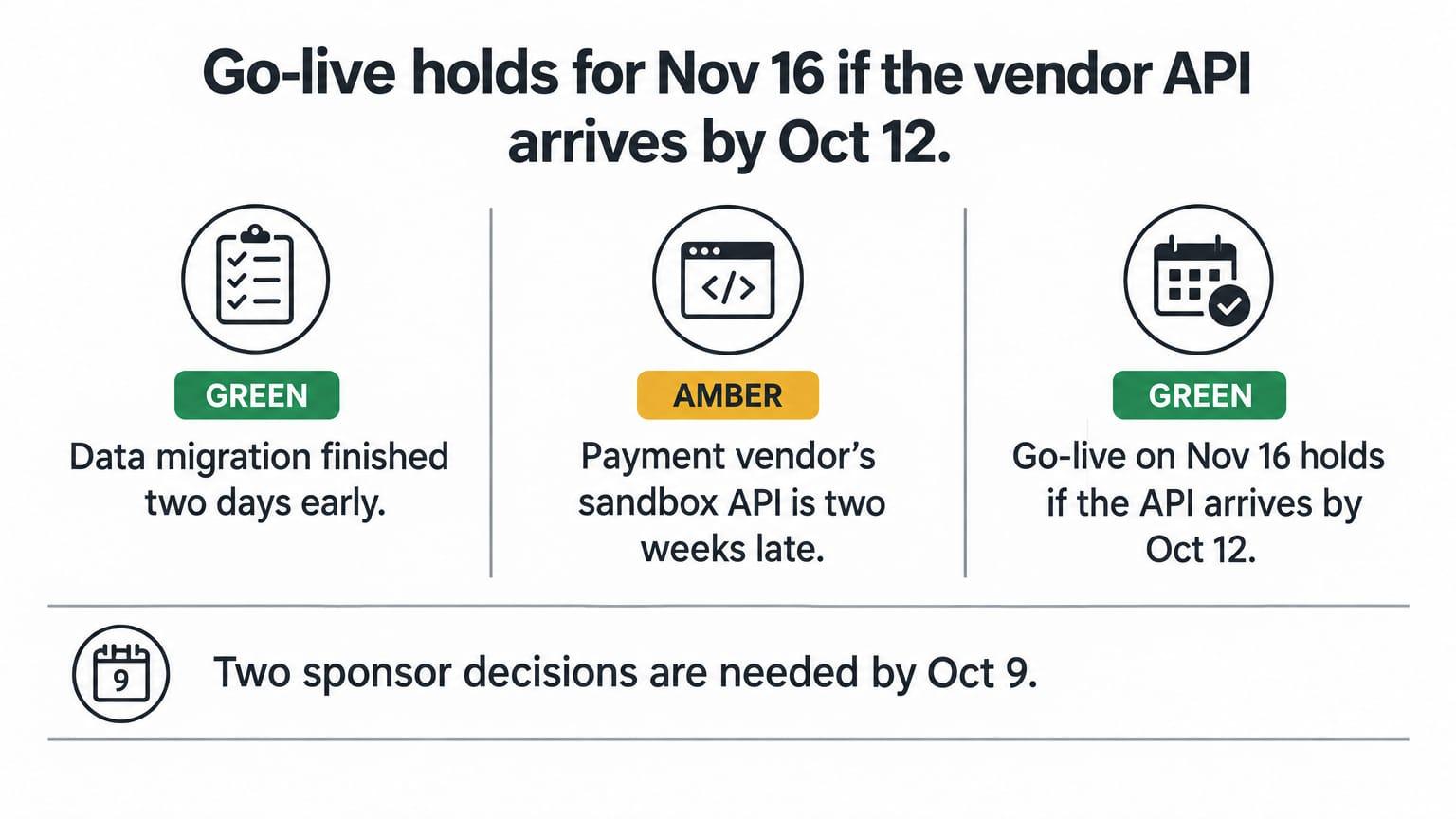

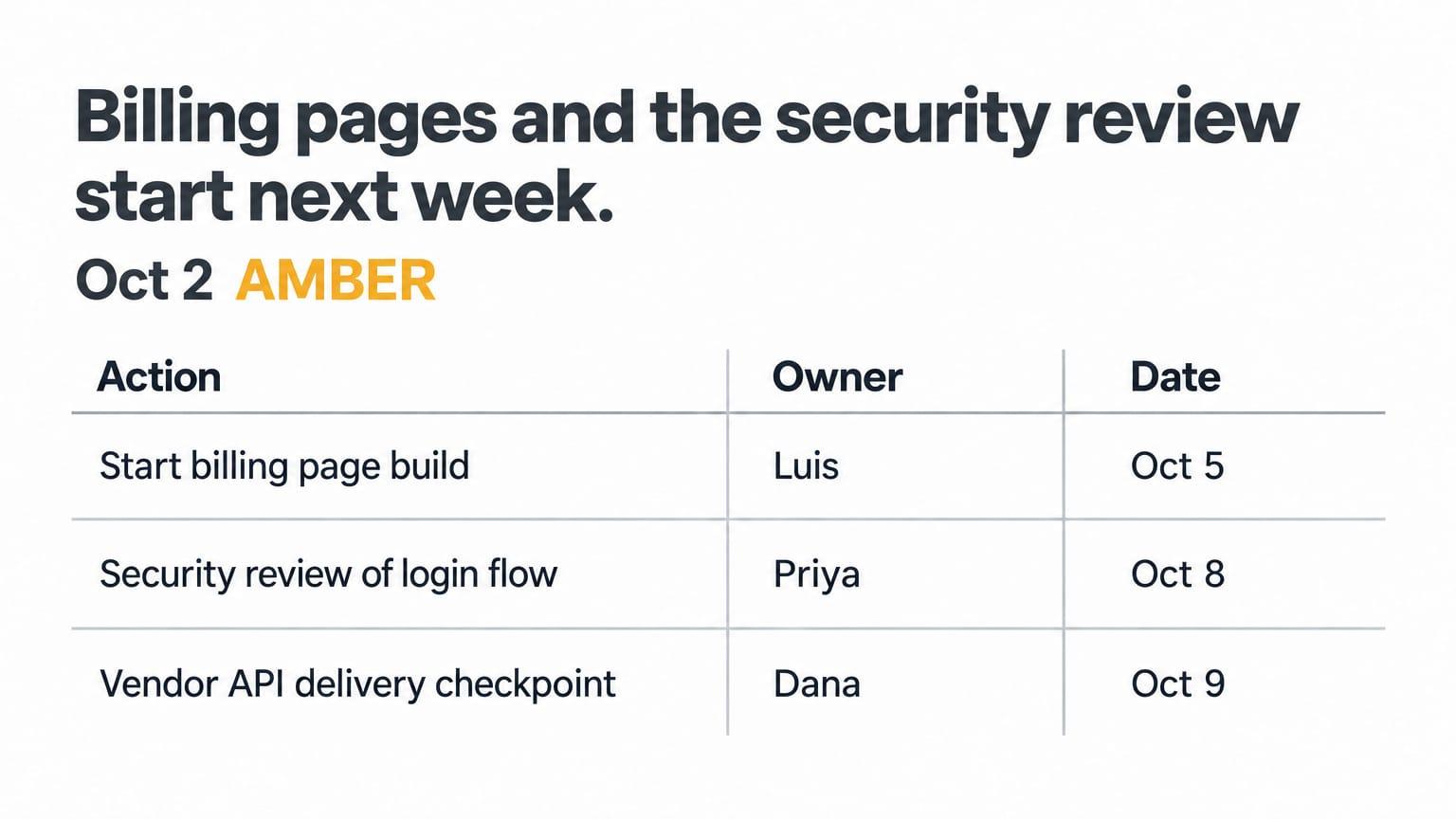

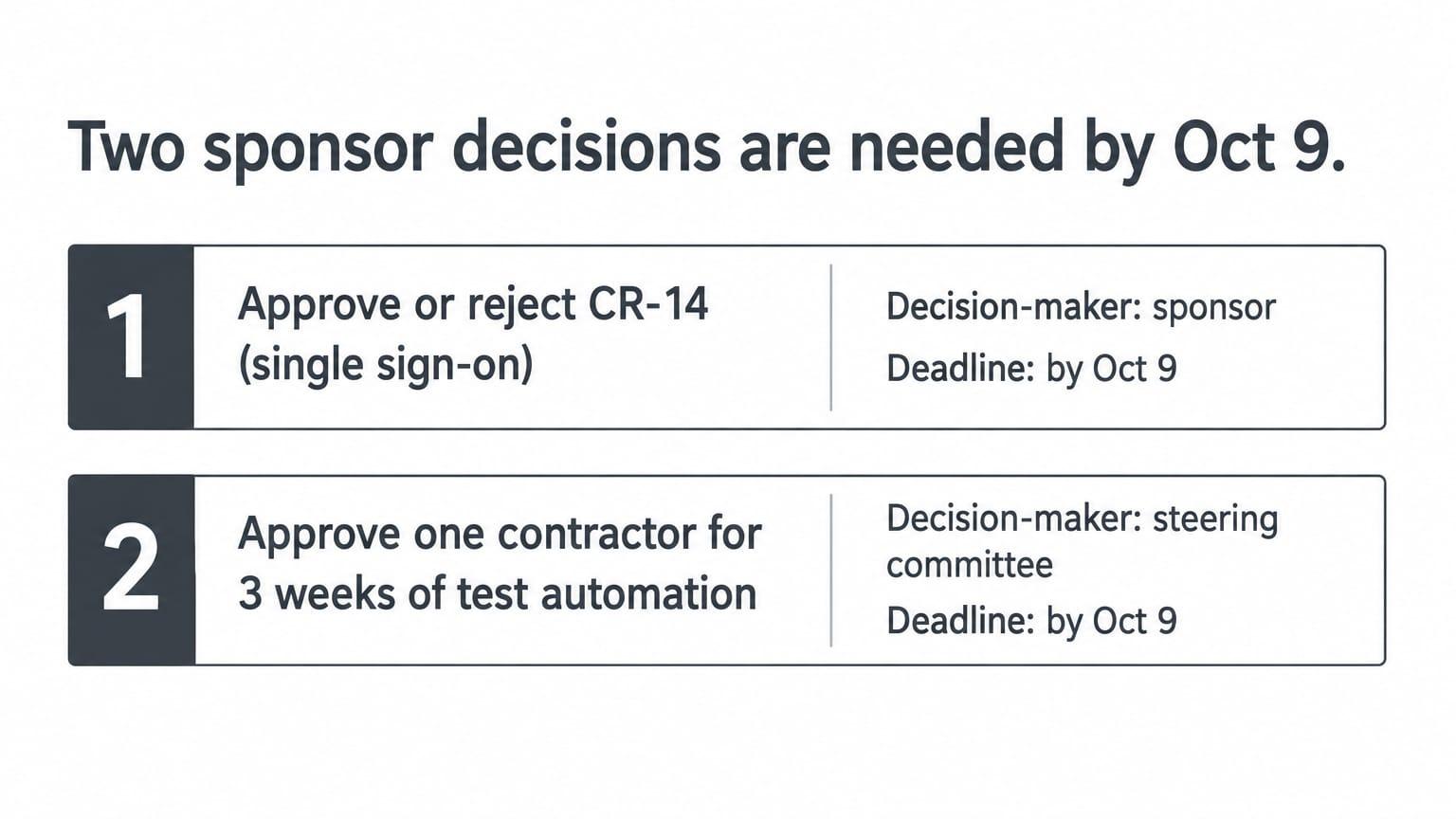

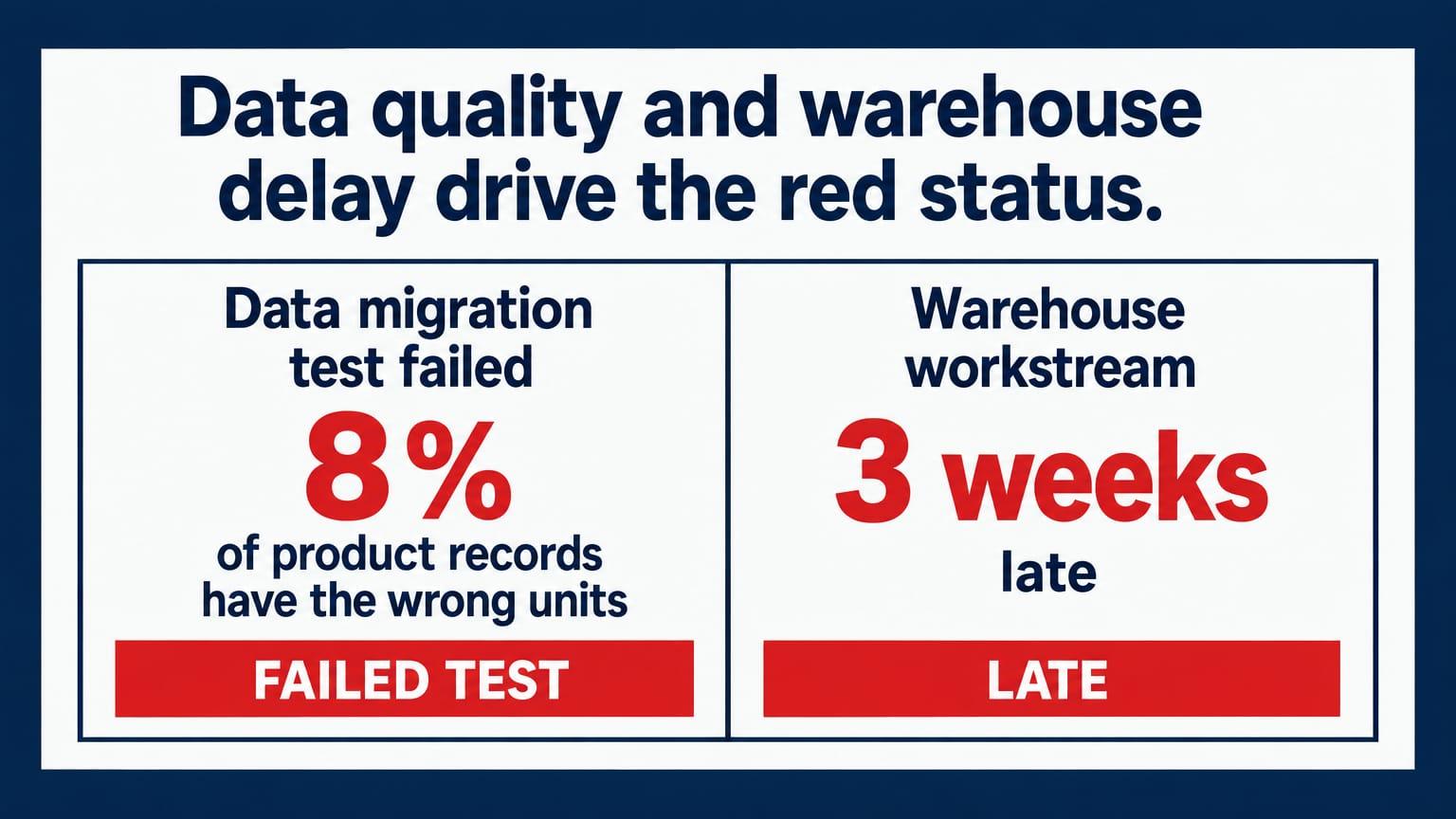

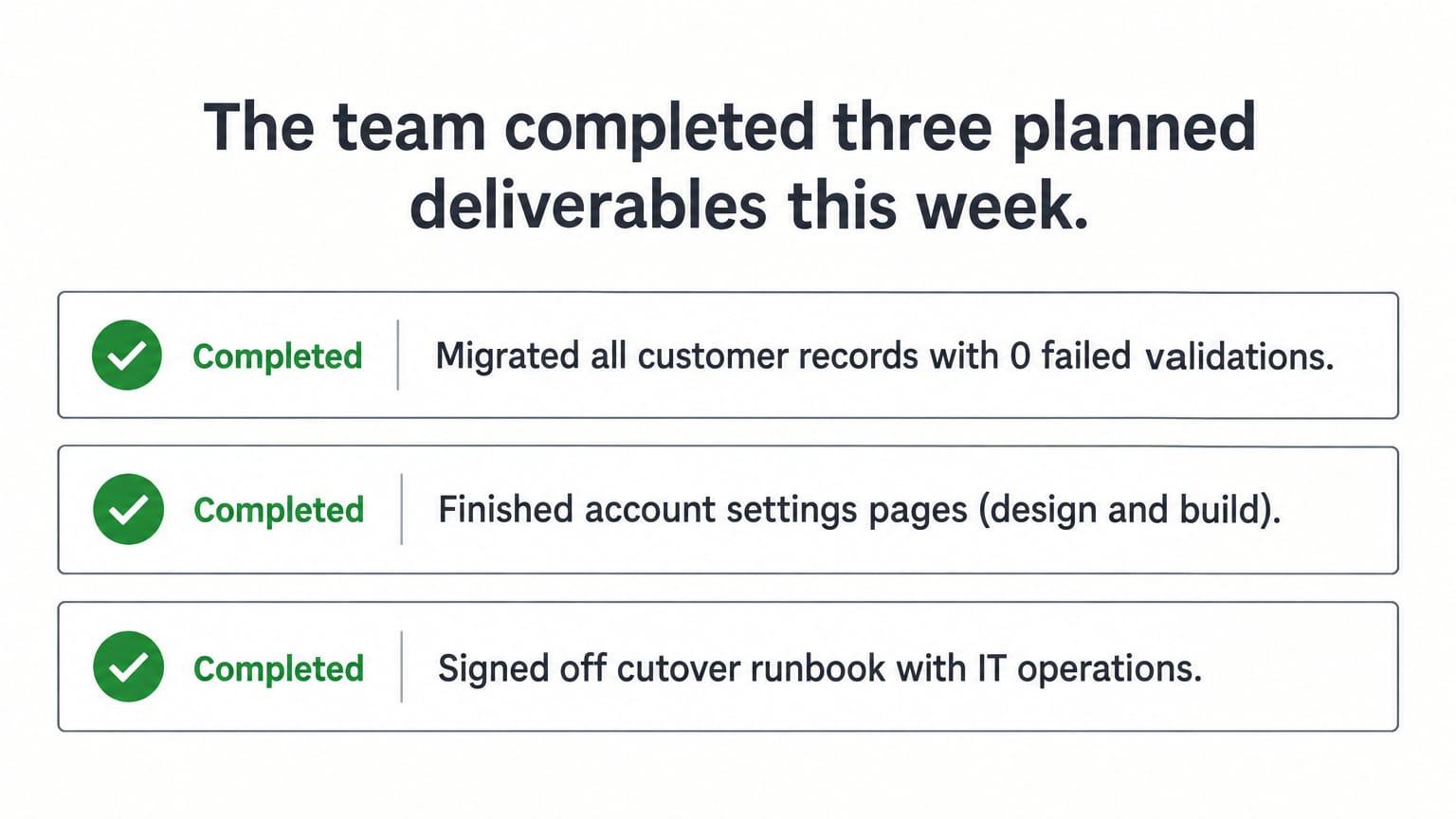

Turn this weekly status report into an 8-slide project status deck for the sponsor. Slide order: 1 title with the reporting period and the overall status, 2 executive summary, 3 RAG dashboard, 4 progress since the last report, 5 plan for next week, 6 risks and blockers, 7 key dates, 8 decisions needed. Rules: write each slide title as a full sentence that states the conclusion. Show each status as a colour and a word. One idea per slide. Style: plain and businesslike, white background, dark grey text, and red, amber, and green only for status. No logos. Customer portal migration weekly status: AMBER, week ending Oct 2 Overall status: AMBER Summary: Data migration finished two days early. The payment vendor's sandbox API is two weeks late, but go-live on Nov 16 holds if it arrives by Oct 12. We need two decisions from you by Oct 9. Status by area Schedule: AMBER - integration test may start 1 week late Scope: AMBER - CR-14 (single sign-on) waits for approval Budget: GREEN - $184,000 spent of $200,000 planned to date Risk: AMBER - one vendor dependency on the critical path Done this week - Migrated all customer records with 0 failed validations - Finished the account settings pages (design and build) - Signed off the cutover runbook with IT operations Planned next week - Start the billing page build - Luis - Oct 5 - Security review of the login flow - Priya - Oct 8 - Vendor API delivery checkpoint - Dana - Oct 9 Blockers and risks - Vendor sandbox API is late. Impact: integration test start slips from Oct 19 to Oct 26. Owner: Dana. Mitigation: build against a mock API from Oct 5. - CR-14 is not approved. Impact: 6 days of work with no slot in the plan. Owner: sponsor. Decisions needed - Approve or reject CR-14 (single sign-on) - sponsor - by Oct 9 - Approve one contractor for 3 weeks of test automation - steering committee - by Oct 9 Key dates - Integration test start: Oct 19 (at risk) - User acceptance testing: Nov 2 (on track) - Go-live: Nov 16 (on track)
The report in this prompt is from the project status report template.
1 message after the prompt

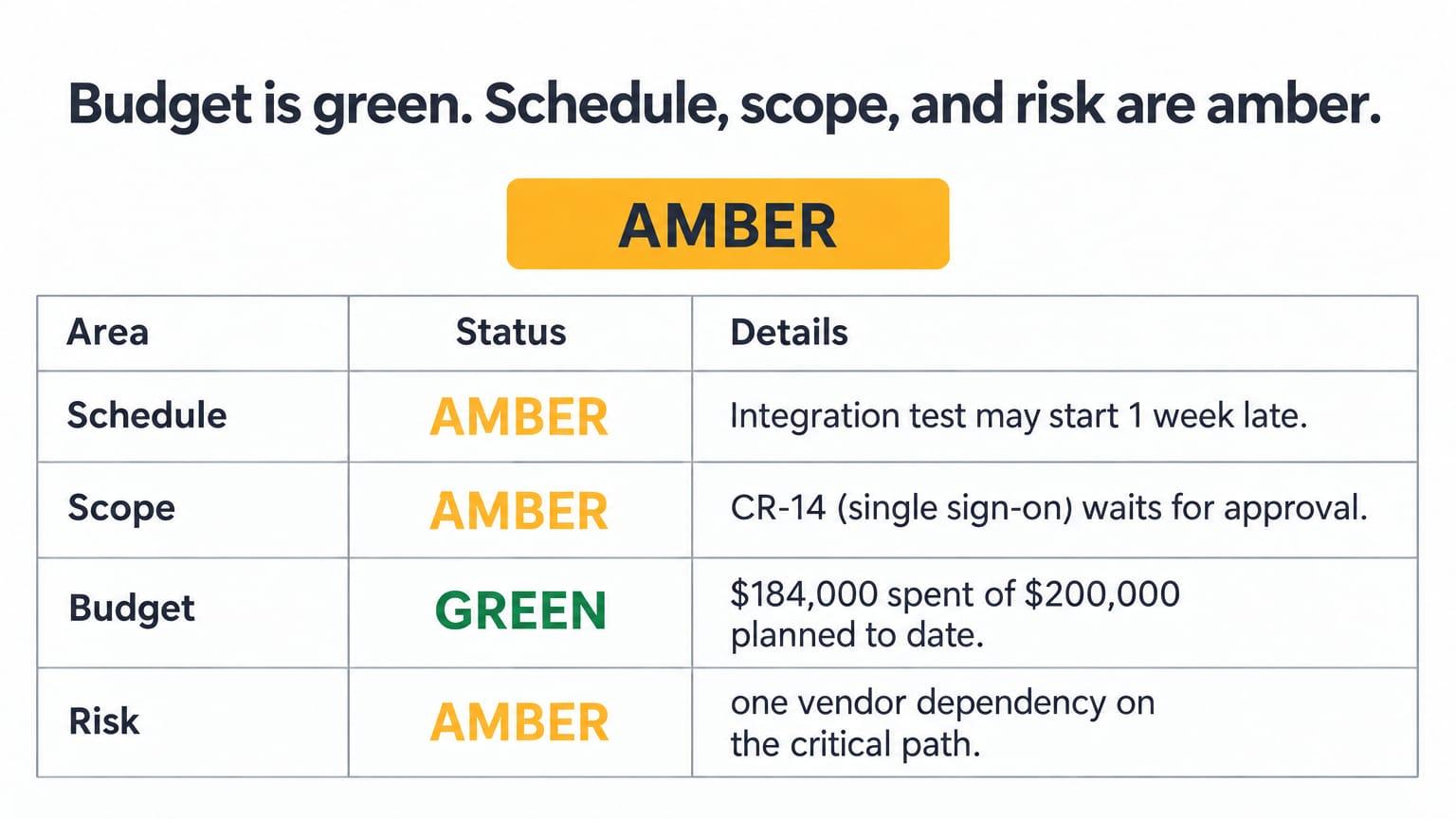

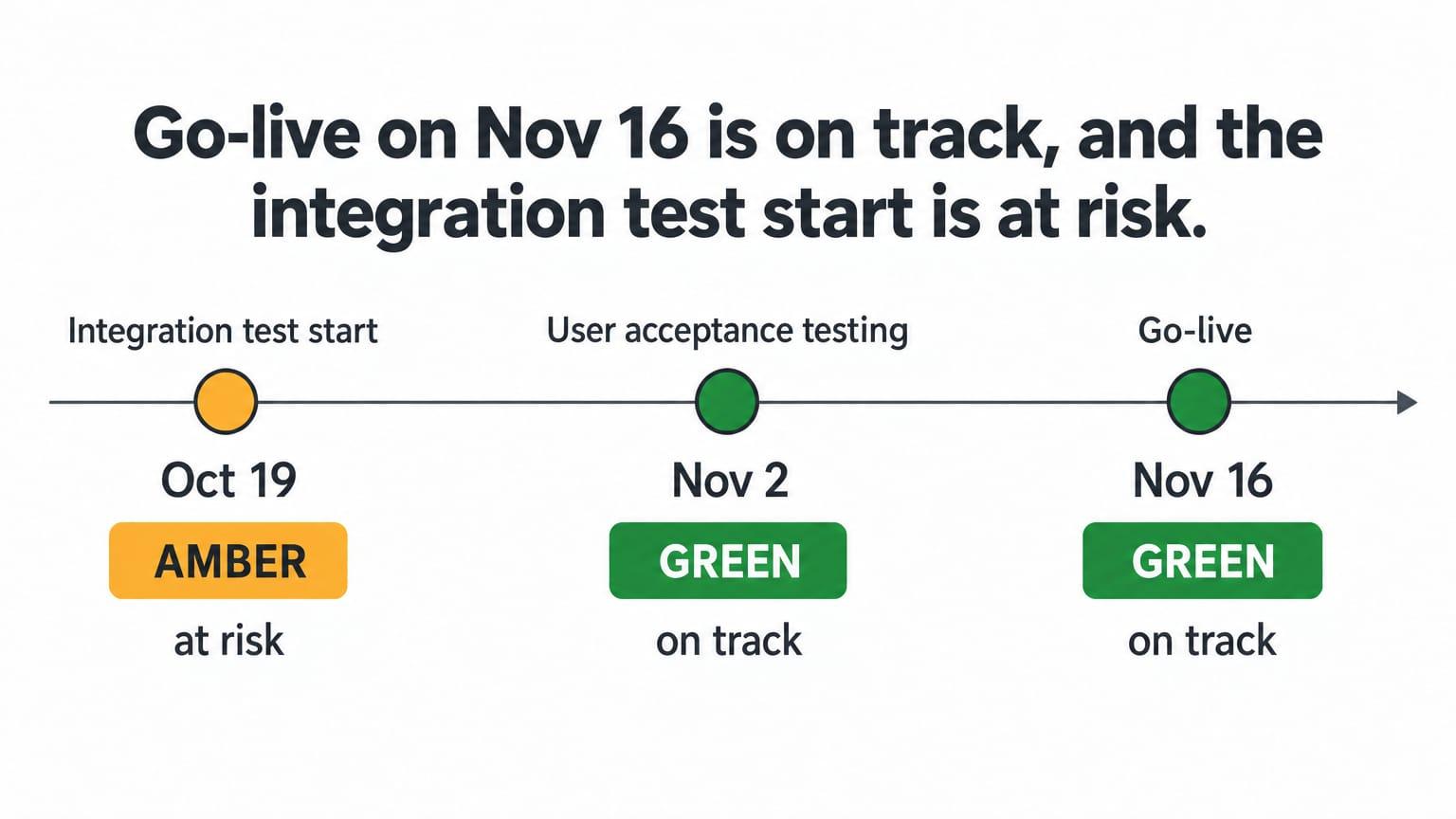

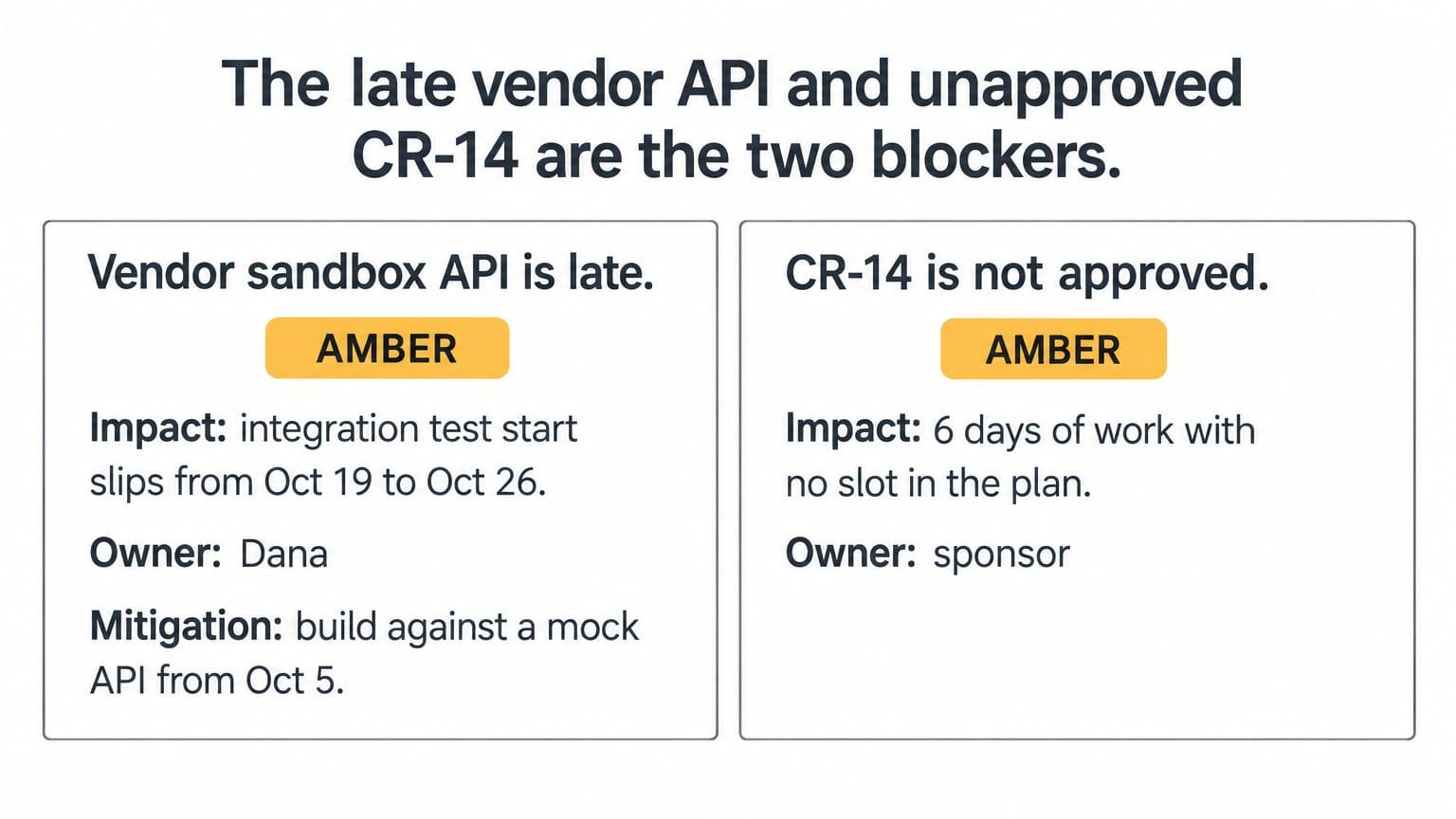

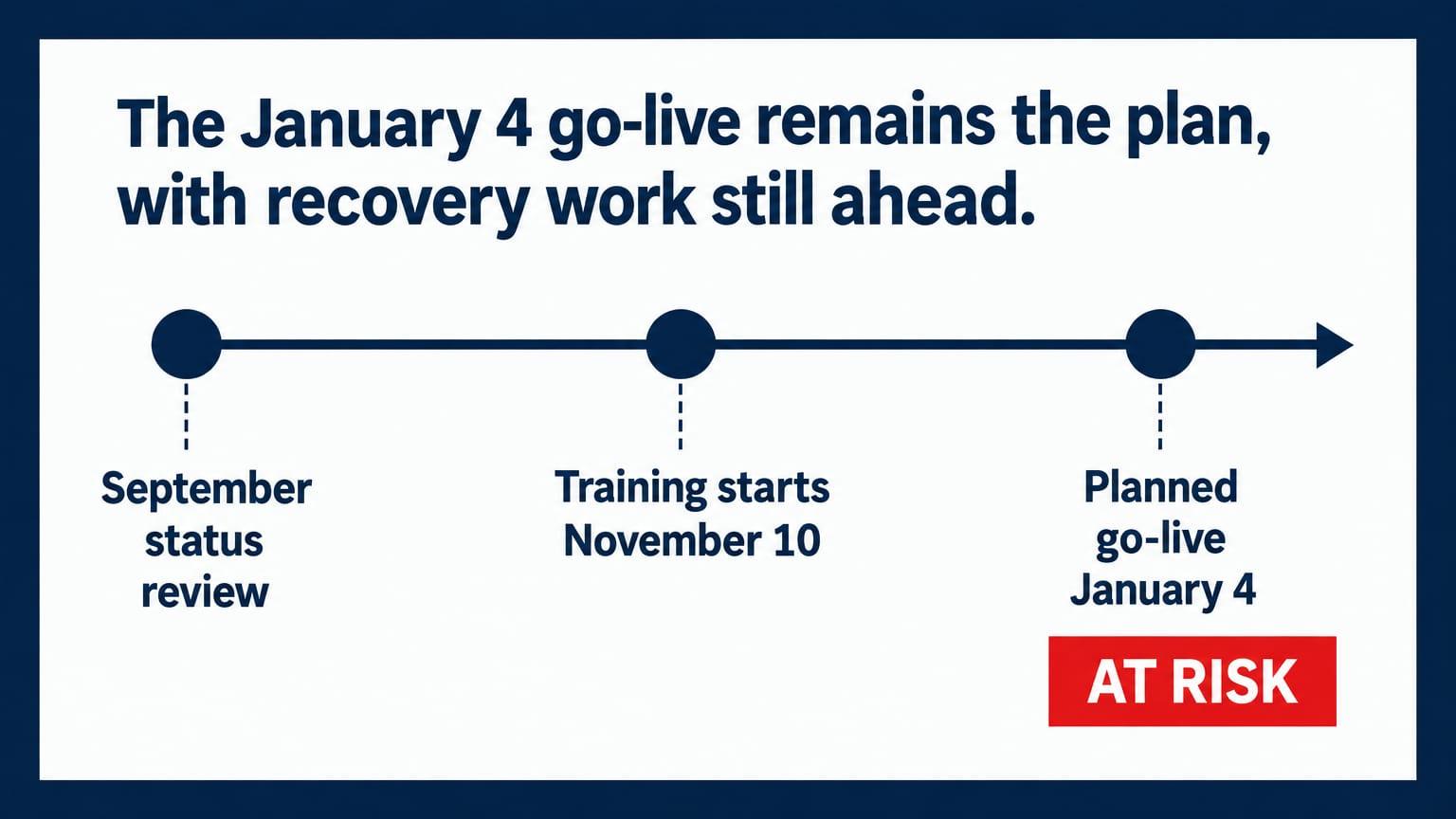

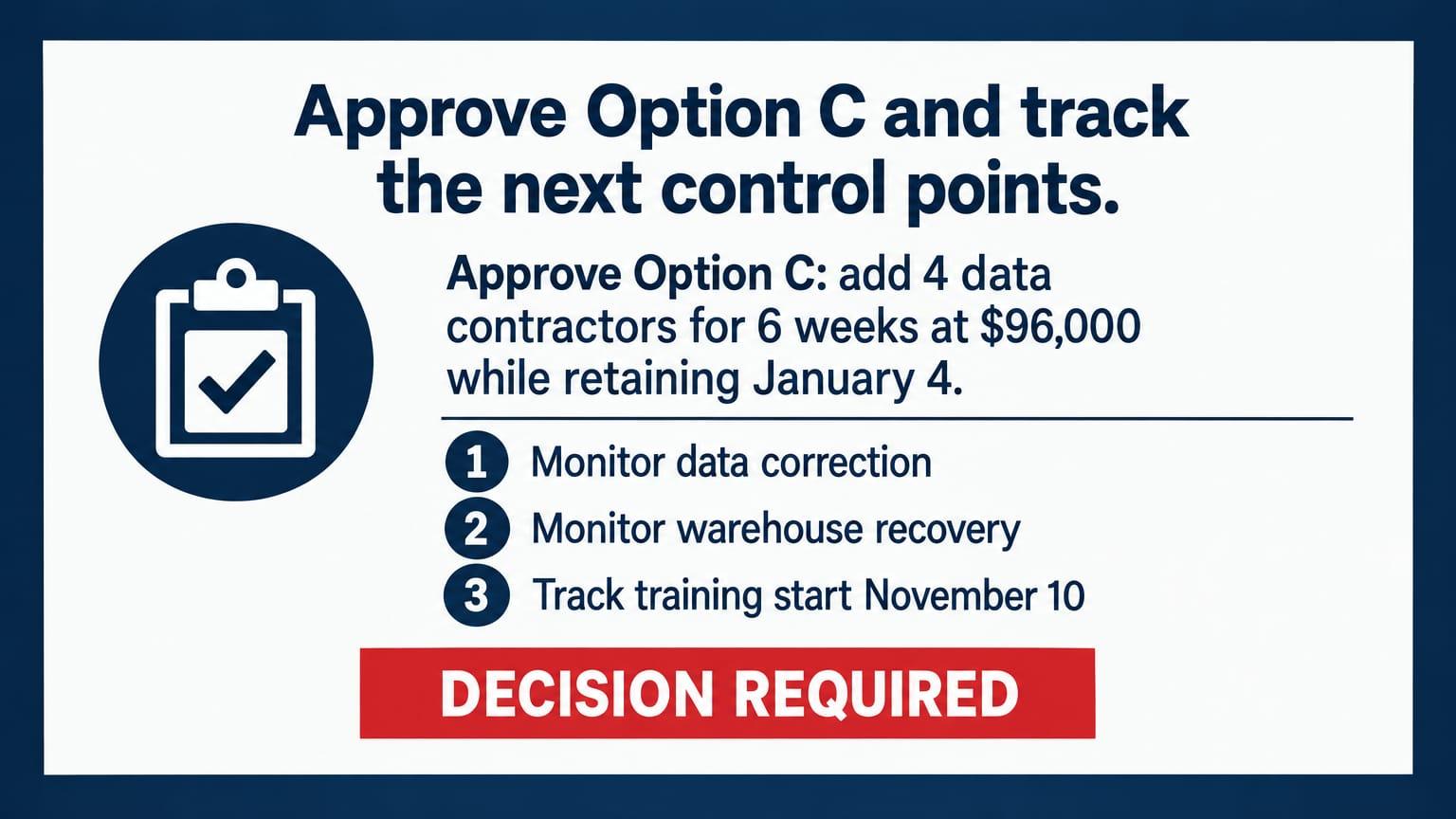

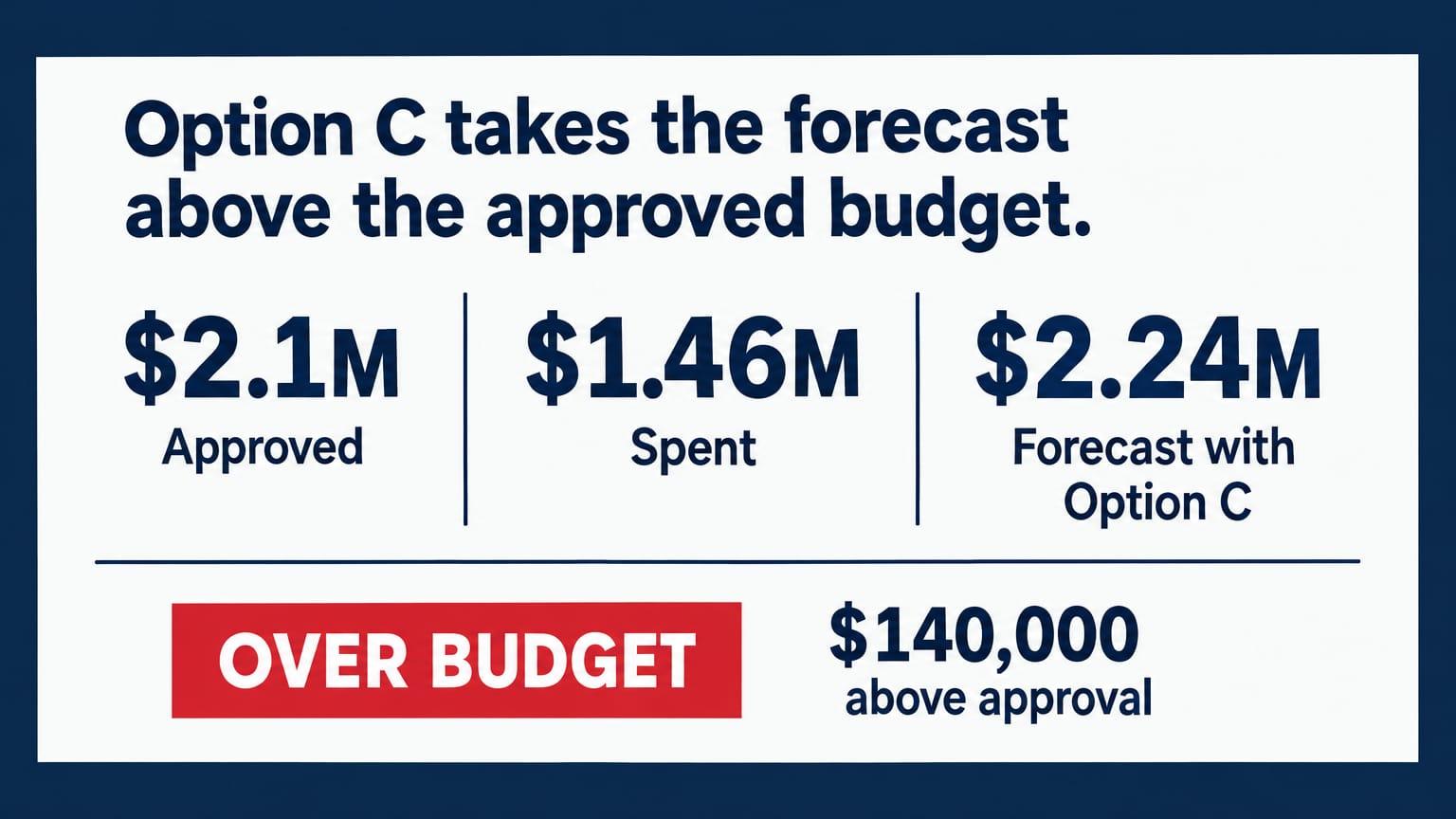

- Slides 2, 3, 5, and 7 use the deck title as the headline. Give each slide a full-sentence headline and keep the design. Slide 2: "Go-live holds for Nov 16 if the vendor API arrives by Oct 12." Slide 3: "Budget is green. Schedule, scope, and risk are amber." Slide 5: "Billing pages and the security review start next week." Slide 7: "Go-live on Nov 16 is on track, and the integration test start is at risk."
